Office/ Field Work Archive

Not promises. Receipts.

A working archive of factory audits, negotiations in progress, inspection days and sealed containers — selected from real orders handled by this office. Names and exact figures are masked where clients require it; the work is real.

120+
Factories audited
38
Categories sourced
2.4M
USD negotiated down (yr)
0
Containers uninspected
Filter by stage
Factory Audit

Verified a "manufacturer" — and found the real one 40km away.

Hardware · Shandong Category · Location
Q1 2026

A European buyer sent an Alibaba-listed "manufacturer" for verification before placing a USD 86k order. The address on the listing was a 14th-floor office in a trading building — two salespeople, no machinery.

I traced the actual production back to a family workshop 40km outside the city. Smaller than claimed, but the owner was the real boss, the price dropped 18%, and quality control sat 30 metres from his desk.

The buyer placed the order with the real factory directly. The "manufacturer" was a middleman who would have outsourced the same workshop at a markup.

Outcome

18% price reduction · real factory identified · order placed direct

Negotiation

From USD 0.82 down to 0.54 per unit — three rounds, face to face.

Packaging · Zhejiang Category · Location
Q4 2025

A US e-commerce brand needed custom rigid boxes at a target of USD 0.60. The factory's opening quote was 0.82 — "our best price, take it or leave it." The buyer was ready to walk.

I went in person. Round one: I showed the boss a competitor quote from a neighbouring province for the same spec at 0.61. He came down to 0.72. Round two: I offered 40% advance payment and a 60-day repeat order commitment. He hit 0.62. Round three: I pointed out a material substitution that would save him 4% on board stock without visible difference. Final: USD 0.54 per unit.

The buyer's target was 0.60. We landed 10% under it.

Outcome

34% price reduction · 10% under buyer's target · 60-day repeat secured

Inspection

Caught a 4.2% defect rate — before the container sailed.

Home & Kitchen · Guangdong Category · Location
Q1 2026

An Australian retailer ordered 12,000 ceramic mugs. The factory's own QC reported "pass." I ran an independent AQL 2.5 inspection the day before loading.

Random sample of 315 units: 13 had glaze pinholes, 7 had uneven rims, 3 had print smudging — a 7.3% major defect rate, well above the 2.5% limit. I held the load. The factory reworked the affected batch over 48 hours; I re-inspected and cleared it at 0.9%.

The container sailed three days late. The buyer received zero defective units at retail. Cost of re-inspection: a fraction of one customer-return wave.

Outcome

7.3% → 0.9% defect rate · zero retail returns · 3-day delay avoided a recall

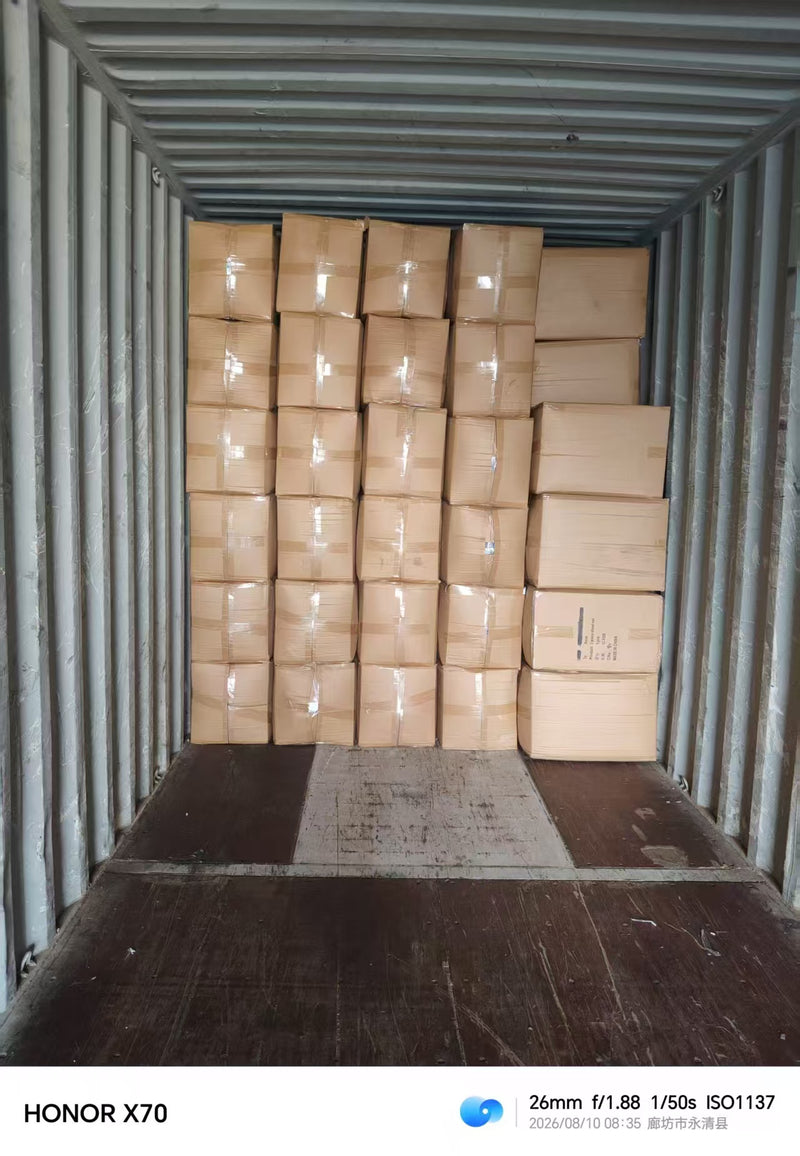

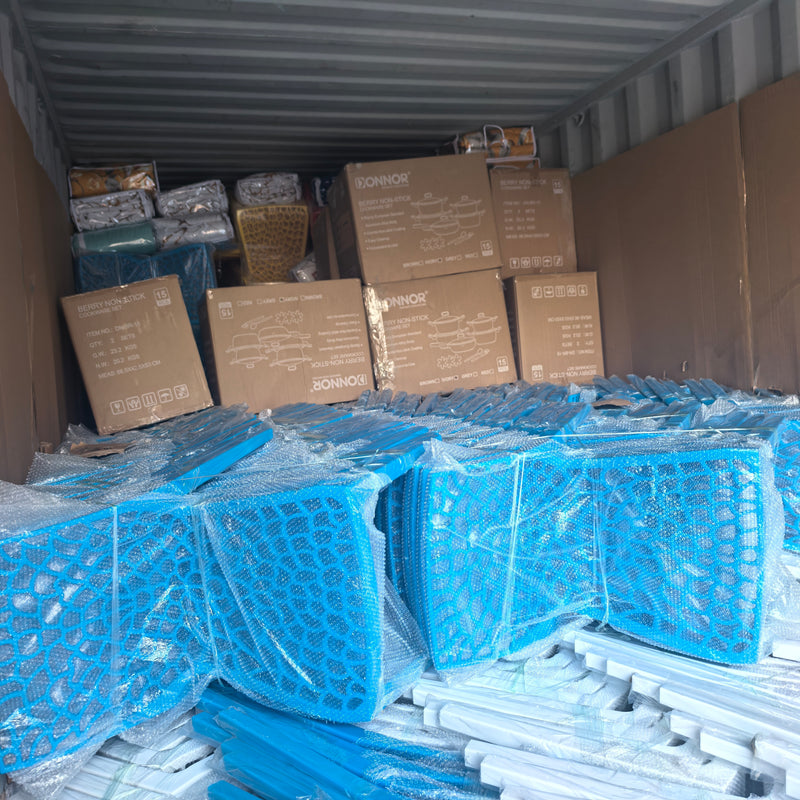

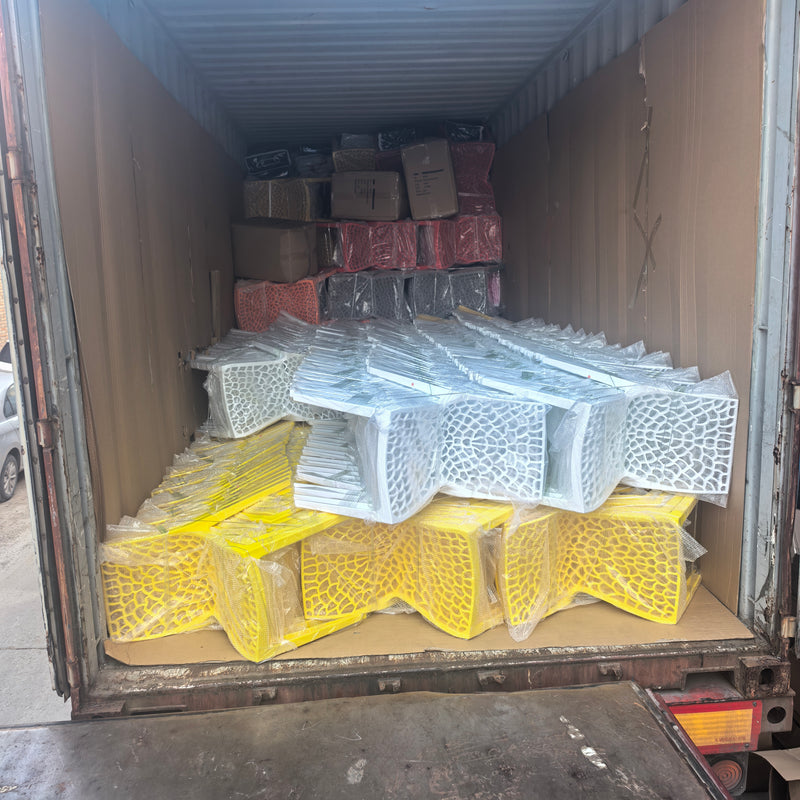

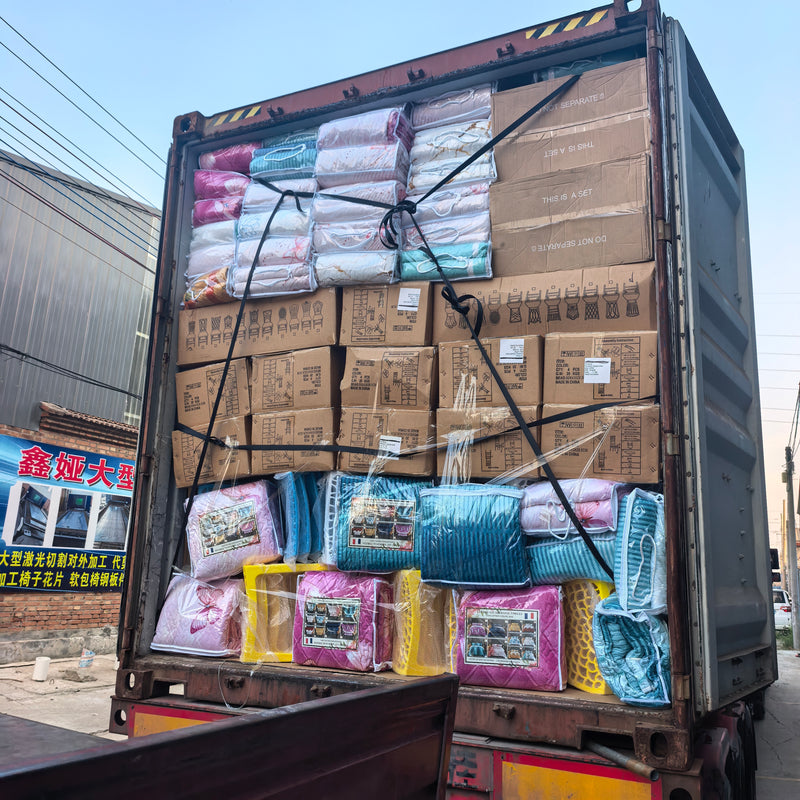

Shipping

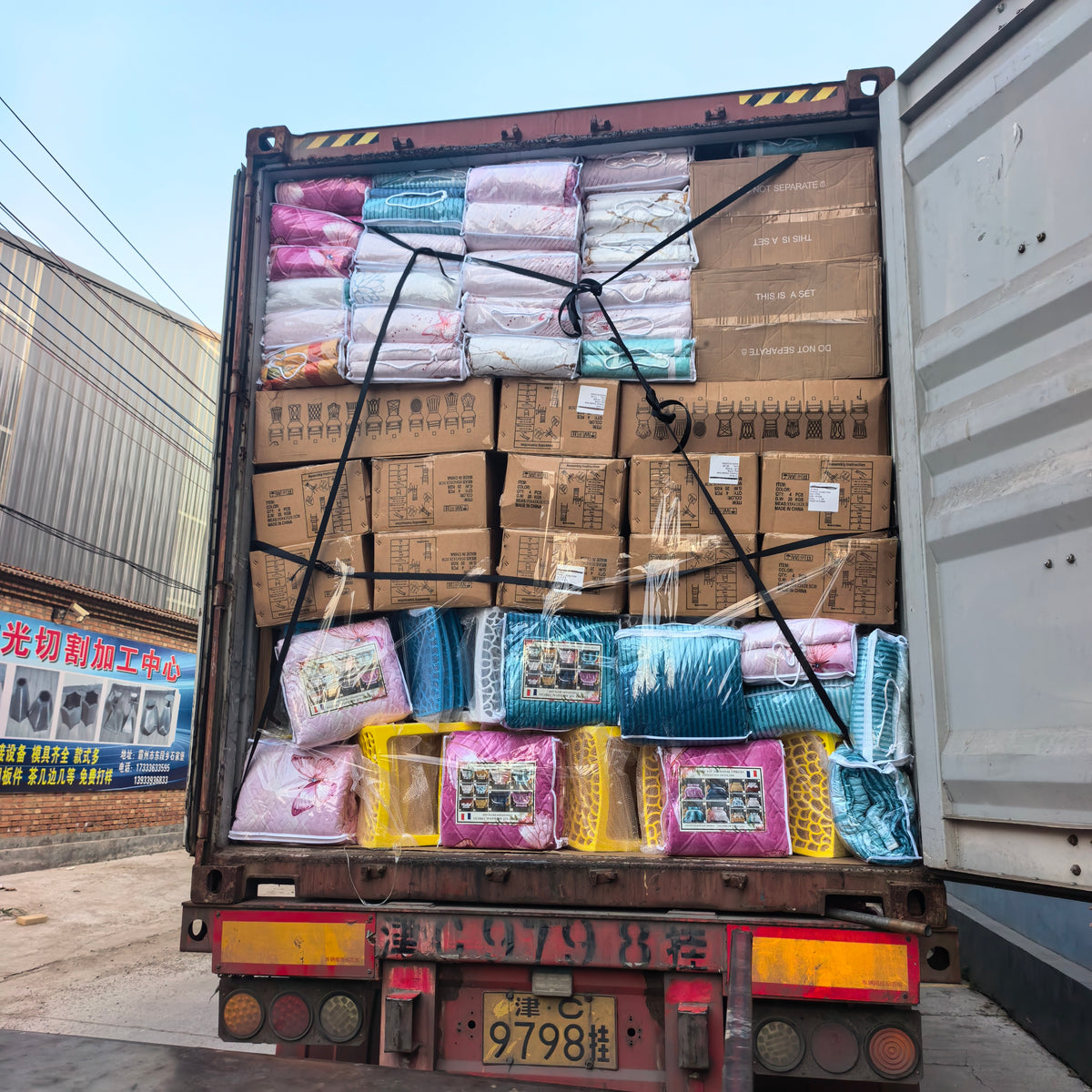

Consolidated three suppliers into one container — saved 41% on freight.

Multi-category · Yiwu → Rotterdam Category · Location
Q4 2025

A UK buyer was about to ship three LCL (less-than-container) shipments from three separate Yiwu suppliers — total freight quoted at USD 4,800, plus three sets of handling and document fees.

I had all three suppliers deliver to my forwarder's warehouse in Yiwu on the same week. We repacked, consolidated into a single 20ft FCL, and booked direct to Rotterdam. Total freight + handling: USD 2,840.

One bill of lading, one customs clearance, one delivery to the buyer's warehouse. Freight cost down 41%, transit time two days faster than the original LCL plan.

Outcome

41% freight saved · 3 shipments → 1 FCL · 2 days faster transit

Factory Audit

Found the hidden capacity behind a "fully booked" supplier.

Apparel · Hebei Category · Location
Q3 2025

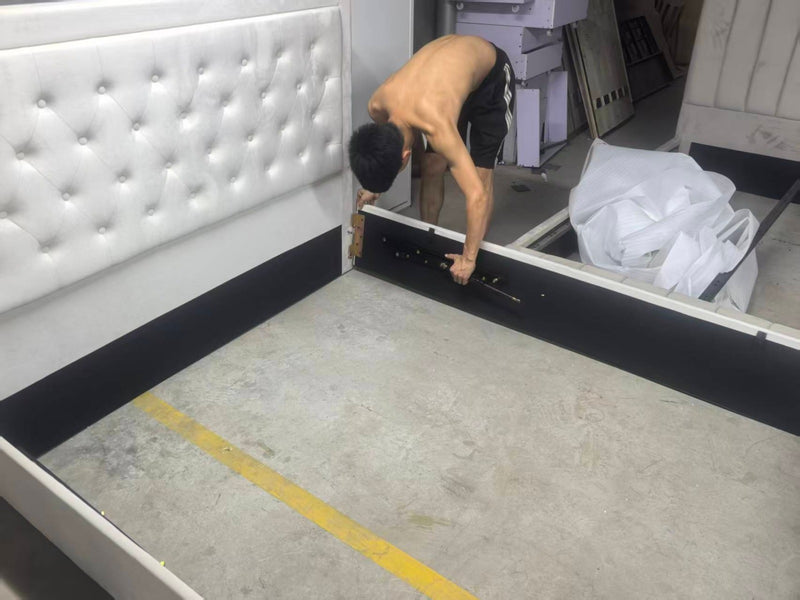

A Canadian apparel brand wanted 50,000 units of a knit style for spring launch. Their existing supplier said "lead time 90 days, no earlier — fully booked." Spring launch would miss.

I audited the supplier in person. The main line was indeed booked, but the owner ran a second, smaller workshop 20 minutes away that wasn't on any listing. Same owner, same QC standard, idle capacity for 30,000 units/month.

I split the order across both lines: 30k at the satellite, 20k at the main. Lead time dropped from 90 days to 52 days. Spring launch on schedule.

Outcome

90 → 52 day lead time · hidden capacity unlocked · launch on schedule
